Risiko Investasi dalam Pembangunan Jalan Tol di Indonesia

Abstract

In accordance with an effort to increase economic development for the welfare of the society, the government of Republic of Indonesia plan to develop infrastructures, including toll road, in a big scale. On the contrary to the high investment potential, there are some risks arise and have to be faced by government and investors. These risks has to be taken into account in investment cal culation as a whole and managed very well since the beginning so that it can be anticipated as early as possible. Risk management is a well and systematic approach to manage these risk, started from risk identification and responses. In toll business, t here are so many risk have to be faced in every stage, from planning, construction until operation and maintenance stages, with the magnitude of very small to very big and probability occurrence from very rare to always happen. In this case, attitude toward this risk are accept, mitigate, transfer to other party, or avoid at all. Regional/Local government could participate in toll road development, either as part of regulator or investor, this might slightly change risk implication.

Keywords

I. LATAR BELAKANG

Dalam upaya mempercepat peningkatan kehidupan ekonomi dan kesejahteraan masyarakat, maka pemerintah sudah mencanangkan untuk melakukan pembangunan infrastruktur, diantaranya jalan tol, untuk mendukung percepatan peningkatan aktivitas perekonomian tersebut, dengan skala yang relatif cukup besar yaitu sepanjang 1150 km dalam kurun waktu 5 tahun (2004 – 2009) ini dengan biaya sekitar Rp. 90 Trilyun (BPJT, 2007).

Untuk bisa mewujudkan target tsb, maka Badan Pengatur Jalan Tol (BPJT) yang ditugaskan untuk memproses pelaksanakan pembangunan itu, kini sedang giat melakukan persiapan pelelangan ruas-ruas jalan tol dengan melibatkan para investor, baik dari dalam maupun luar negeri.

Salah satu subjek negosiasi antara pemerintah, c.q BPJT dengan para investor itu adalah dalam hal memperkirakan risiko yang akan dihadapi dalam

investasi jalan tol tersebut, baik dari sisi pemerintah, maupun dari sisi investor. Banyak parameter yang terkait dengan risiko tersebut, baik dari segi internal pelaksanaan ivestasi itu sendiri, seperti rancangan teknis, jadwal kegiatan dsb, yang notabene relatif bisa dikendalikan baik oleh pemerintah maupun investor, maupun yang terkait dengan segi external investasi, seperti kondisi kestabilan politik dan keamanan, serta kondisi ekonomi makro dunia yang sangat sukar ditebak kejadian dan pengendaliannya.

Namun demikian, sejalan dengan rencana investasi yang harus dilakukan dan besarnya pendanaan yang dibutuhkan, maka untuk mengantisipasi kerugian yang bisa timbul, risiko-risiko yang terkait dengan investasi tersebut harus dapat diketahui juga dan dievaluasi solusi untuk mengahadapinya. Untuk itu maka diperlukan suatu kajian untuk menganalisis risiko yang mungkin terjadi tersebut. Kajian yang biasanya dilakukan meliputi :

  • 1. Identifikasi terhadap faktor kemungkinan terjadinya risiko kegagalan pada suatu investasi di jalan tol berikut mengenali metoda analisis risiko yang dianggap sesuai serta prosedur standar penggunaannya.
  • 2. Menentukan antisipasi hal-hal yang harus dilakukan untuk menekan kemungkinan risiko yang dapat timbul tersebut yang pantas untuk diterapkan, dan mungkin bisa berlaku secara umum ataupun berbeda sesuai dengan kasus per kasus yang ditemui.

Tulisan ini bertujuan untuk memberikan gambaran tentang penerapan analisis risiko dalam investasi pembangunan jalan tol di Indonesia dengan pemberian contoh-contoh analisis yang dilakukan dalam beberapa kasus. Dimulai dengan teori tentang analisis risiko itu sendiri, kemudian contoh penerapan analisis dan praktek pelaksanaannya. Terakhir, diulas juga peluang partisipasi Pemerintah Daerah dalam pembangunan jalan tol berikut implikasi risikonya.

II. ANALISIS RISIKO

Pada dasarnya, setiap investasi pasti membawa risiko didalamnya, dan dalam hal ini investasi bisnis jalan tol termasuk salah satu proyek yang sangat dipengaruhi risiko dan ketidak pastian. (Dalijus, 2007)

Menurut artinya, risiko adalah sesuatu yang terjadi diluar rencana yang dapat berpengaruh negatif atau merugikan terhadap usaha yang akan/sedang dilakukan (Sunito, 2005). Risiko ini merupakan sesuatu yang timbul akibat adanya kemungkinan atau ketidak pastian. Terkadang risiko ini diklasifikasikan sebagai risiko murni dan risiko spekulatif sementara menurut

sumbernya risiko ini dapat diklasifikasikan kedalam risiko sosial, risiko fisik ataupun risiko ekonomi/finansial.

Sebagaimana halnya dalam setiap proyek infrastruktur, maka dalam program pembangunan jaringan jalan tol inipun terdapat berbagai macam risiko yang dapat menyebabkan kegagalan atau mengurangi kelancaran dan kesuksesan dari suatu proyek jalan tol. Risiko kegagalan tersebut dapat terjadi atau dialami oleh berbagai pihak yang terlibat, baik pemerintah maupun pihak swasta seperti investor, kontraktor, pemasok dll. Risiko ini juga dapat terjadi disetiap tahapan program pembangunan ini, mulai dari tahap perumusan kebijakan, perencanaan, pelaksanaan serta operasi dan pemeliharaan. Pada dasarnya, risiko tersebut ada yang bersifat internal proyek dan dapat ditanggulangi, namun ada juga yang bersifat external dan diluar jangkauan untuk dapat ditangani sendiri.

Secara garis besar risiko tersebut kebanyakan mempunyai konsekuensi yang terkait dengan masalah keuangan dan antara lain meliputi misalnya perubahan kebijakan sosial politik (misalnya akibat pergantian pemerintahan atau pejabat berwenang dll), hukum dan birokrasi (perubahan peraturan, prosedur perijinan, penyediaan lahan dll), perbankan (misalnya perubahan tingkat suku bunga pinjaman, kurs valuta asing dll), teknis (perubahan standar perencanaan, metoda dan jadwal konstruksi, perubahan volume lalu lintas dll) sampai dengan bencana alam, huru-hara atau kondisi force majeur dsb.

Namun pada dasarnya, semua risiko tersebut seyogyanya dapat diperkirakan dan turut diperhitungkan dalam penyusunan pogram pembangunan jalan tol ini dan dikelola secara tepat sesuai dengan manajemen risiko yang akhir-akhir ini sedang dikembangkan. Atau pada saat penyusunan bisnis plan, dilakukan juga analisis sensitivitas untuk mengetahui sejauh mana risiko perubahan yang terjadi akan turut mempengaruhi pelaksanaan proyek tersebut.

Manajemen risiko ini sendiri didefinisikan sebagai cara sistimatis untuk meminimalkan risiko dengan memanfaatkan fungsi-fungsi manajemen dalam mengidentifikasi, mengukur dan menentukan tingkat risiko yang dihadapi serta menyusun strategi untuk menanggulanginya. Langkah-langkah yang dilakukan dalam manajemen risiko biasanya diawali dengan identifikasi risiko yang dihadapai (risk identification), yang kemudian dilanjutkan dengan analisis dan penyikapan terhadap risiko tersebut (risk analysis and risk respons) dan selanjutnya merumuskan tindakan dalam menghadapi risiko tersebut (risk treatment).

Dalam menghadapi risiko tersebut, tindakan yang dapat dilakukan adalah menerima atau menanggungnya (absoption), mengalihkan kepihak lain

(transfer), mengurangi (reduction) atau menghindari (avoidance). Menerima risiko artinya siap menanggung konsekuensi dari timbulnya risiko tersebut, yaitu misalnya dengan menyiapkan dana untuk menutup kerugian yang mungkin timbul dari risiko tersebut, sementara tindakan mengalihkan risiko ke pihak lain dilakukan misalnya dengan asuransi, out sourcing dll. Tindakan mengurangi risiko dan menghindari risiko bisa dilakukan dengan mengatur klausul-klausul tertentu dalam perjanjian kontrak

Keseluruhan langkah-langkah proses manajemen risiko tersebut di ilustrasikan dalam Gambar 1.

3

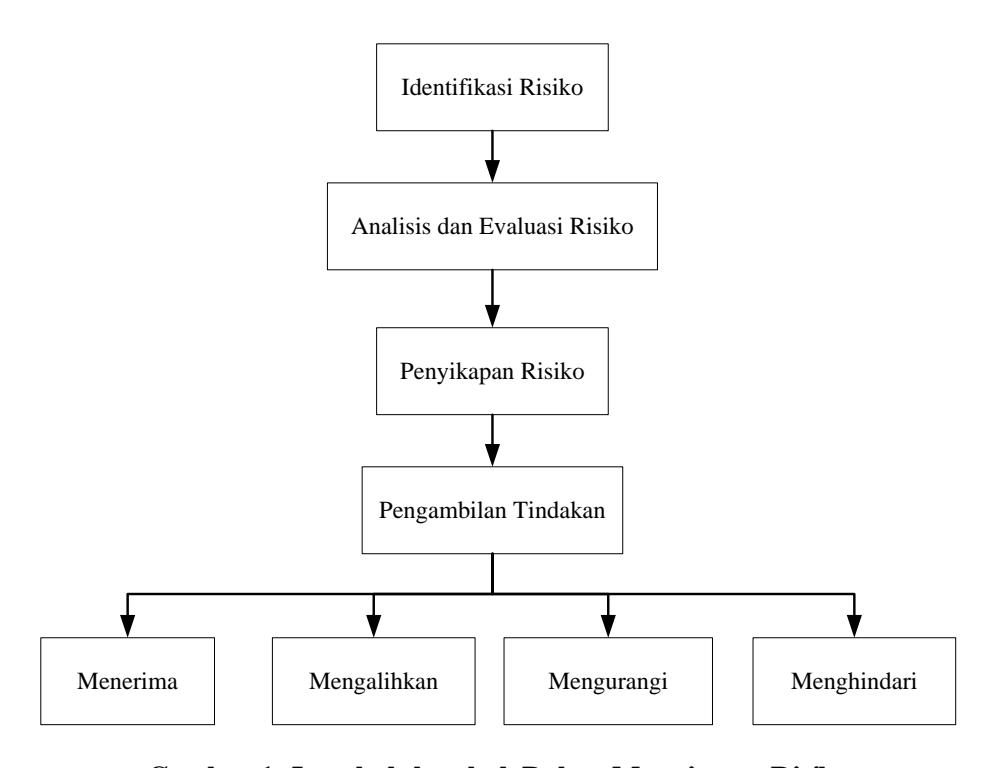

Gambar 1. Langkah-langkah Dalam Manajemen Risiko

Identifikasi risiko dapat dilakukan dengan berbagai cara, seperti misalnya menggunakan chek list, melalui diskusi kelompok, menggunakan questionnaire, atau simulasi. (Okamoto et all, 2007)

Dilihat dari besaran/tingkat risiko yang mungkin terjadi, dapat dilakukan analisis lebih lanjut, baik secara kualitatif, misalnya dengan membagi risiko kedalam 5 tingkatan yang biasa dihadapi, yaitu dapat diabaikan, rendah, sedang, besar dan fatal. Analisis ini dapat juga dilakukan secara kuantitatif, melalui perhitungan, estimasi atau cara lainnya.

Sementara dari kecenderungan terjadinya, terdapat 5 tingkatan juga, yaitu jarang, kadang-kadang, mungkin, sering dan selalu (Jasa Marga, 2006). Kecenderungan ini dapat pula diprediksi secara kuantitatif, misalnya berdasarkan simulasi atau data empiris kejadian yang sama dan terjadi di proyek lainnya.

Kombinasi dari besaran dan kecenderungan terjadinya itu biasanya dipresentasikan dalam sebuah matriks risiko seperti yang diperlihatkan contoh secara kualitatif pada Gambar 2.

Tingkat/ProbabilityJarangTerkadangMungkinSeringSelalu
Dapat diabaikan
Rendah
Sedang
Besar
Fatal

Gambar 2. Matriks Risiko

III. IDENTIFIKASI RISIKO INVESTASI TOL

Dalam bisnis Jalan Tol, yang relatif mempunyai siklus yang cukup panjang dari mulai inisiasi proyek sampai pengoperasian dan pengakhiran konsesi yang bisa berdurasi puluhan tahun, Sihombing (2003) mengidentifikasi 53 jenis risiko pembangunan jalan tol ini menurut siklus proyek (Konsep/Pra studi kelayakan, Studi Kelayakan dan Negosiasi, Perancangan, Pelaksanaan, Penyelesaian/Final Hand Over serta Pengoperasian) seperti terlihat pada Tabel 1.

Dari Tabel 1, terlihat bahwa risiko yang paling banyak adalah dalam waktu pelaksanaan proyek, sehingga fase ini menjadi sangat kritis sifatnya dalam pelaksanaan investasi ini dan harus ditangani dengan sangat hati-hati.

Tabel 1. Identifikasi Risiko Menurut Sumbernya Dalam Siklus Proyek

Pra FSFS/NegosiasiPerancanganPelaksanaanPHO/FHOPengoperasian
PraPerubahanBirokrasiPerubahanKegagalanPenilaian
feasibilitykebijakanpersetujuanHarga Satuanpemeliharaanpemeriksaan
studyatau politik
BirokrasiContingentKetidakPengawasanKecelakaan
persetujuanliabilitycocokanmasyarakatLalu lintas
rancangan
dengan
lapangan
PenentuanCash
flow
PerubahanAmortisasiDampak
investorinvestornilai
tukar
lingkungan
uang
PerubahanPembebasanCash
flow
Bencana
alam
harga tanahtanahkontraktordan Huru-hara
FeasibilityPerubahanJaminan
Studylokasipemeliharaan
material
Kegagalan
jaminan
pelaksanaan
Contingent
liabilty
Inflasi
Kerugian
kontraktor
Cash
flow
investor
Tenaga kerja
Pembebasan
tanah
Perubahan
suku bunga
Harga
penawaran
pelelangan
Perubahan
cuaca
PersyaratanPPN Jalan tolKualitasPerpanjanganVolume
lalu
Pemerintahdesainwaktulintas
Daerahpelaksanaan
SistimManajemenKeputusan tarif
Jaringankontraktortol

Sambungan……..Tabel 1. Identifikasi Risiko Menurut Sumbernya Dalam Siklus Proyek

PerubahanKualitas
Regulasipengawasan
Financing
scheme
LiabilityCash FlowDepresiasiKebakaran
Laporan
Keuangan
Tenaga kerja
PersetujuanKualitasKualitas
desainpelaksanaankeseluruhan
Manajemen
proyek
Perubahan
desain,
volume
dan
lingkup kerja
Perijinan
Kontraktual
dan tuntutan
hukum

(Sumber : Sihombing 2003)

Keterangan :

FS : Feasibility Study (Studi Kelayakan)

PHO/FHO : Provision/Final Hand Over (Penyerahan Sementara/Akhir)

Sementara PPITA project (2005) menyusun tabel alokasi risiko menurut pihak yang menanggungnya, yaitu Pemerintah atau Badan Usaha Jalan Tol (BUJT) berikut pembagian, konsekuensi dan tindakan mitigasinya seperti terlihat pada Tabel 2.

Tabel 2. Alokasi Risiko

RisikoPemBUJTShareKonsekuensiMitigasi
1. Pembebasan LahanVPemerintah
berpotensi default
Janji Pemerintah
untuk
memberi
kompensasi
1.1 BiayaV
1.2 WaktuV
1.3 AsuransiV
1.4 Kepastian selesai

Sambungan.............Tabel 2. Alokasi Risiko

1.4.1 JadwalVTerlambat
&
biaya naik
Penyediaan
jaminan
pelaksanaan
&
hak
menunjuk
pemenang
tender
1.4.2 PenghentianV
1.5 Peningkatan biayaVKompromi
&
penghentian awal
Ditunda
2. Pendanaan
2.1 Biaya perancangan
& pelaksanaan
VDefault pinjaman
jangka pendek &
kenaikan biaya
Peraturan
2.2 Biaya OperasiVKenaikan biaya &
default
pinjaman
jangka panjang
Ditunda
2.3 Biaya
pemeliharaan
V
2.4 Kapasitas finansialVDefault
pinjaman/konsesi
Praqualifikasi,
bukti
kemampuan
pendanaan
&
kredit bertahap
2.5 Kepemilikan
2.5.1 Badan hukumVKontrak
null
&
void
Pemerintah
berhak
mengikut
sertakan
kreditor
2.5.2 PerubahanVPengurangan
kapasitas finansial
& operasional
Pemerintah
menahan
persetujuan
setiap
perubahan
2.6 Perubahan
legislatif
VKompromi
&
perbaikan
Pemerintah
&
BUJT
mempunyai hak
yang
sama
merevisi
syarat2.
2.7 Suku bungaV
2.8 InflasiV
2.9 Nilai tukarV

Sambungan........ Tabel 2. Alokasi Risiko

2.10 Resolusi
perselisihan
2.11 Keadaan kahar
V
V
Penghentian
proyek/ditunda,
kenaikan biaya &
waktu
Penghentian
Penetapan sekuen
perselisihan,
dari
tuntutan
s/d
arbitrase dll.
Penetapan kondisi
proyek/kerusakankahar & parameter
persetujuan
bersama
3. Perancangan
3.1 PerancanganVRancangan
sub
standar
&
konstruksi
menyebabkan
kerusakan
Biaya
perbaikan,
kenaikan
biaya
operasi
&
pemeliharaan
3.2 Efektivitas
rancangan
VHasil akhir tidak
sesuai,
RTA
&
AMDAL
tidak
dilaksanakan
Biaya penyesuaian
&
perbaikan
ditanggung swasta
3.3 Variasi
3.3.1 Tidak ada biayaVKenaikan
biaya
mengurangi
kelayakan proyek
Pengenalan
organisasi
&
peraturan
ICE/PSV
3.3.2 Perubahan oleh
pemerintah
VKenaikan
biaya,
proyek terlambat
Penetapan
lingkup,
pembayaran
perubahan
3.3.3 Perubahan oleh
BUJT
VPenghematan
biaya, percepatan
proyek
Persetujuan
tidak
ada biaya & waktu
tambahan
3.4
Lapangan
dan
ROW
VKenaikan
biaya,
terlambat
Pemecahan
masalah
&
pembayaran
kompensasi
4. Pembangunan
4.1 Pembangunan
VRancangan
&
konstruksi
sub
standar
&
kerusakan
Biaya
perbaikan,
kenaikan
biaya
operasi
&
pemeliharaan
4.2 Efektivitas
rancangan
VHasil akhir tidak
sesuai,
RTA
&
AMDAL
tidak
dilaksanakan
Biaya
perbaikan
ditanggung BUJT

Sambungan.......... Tabel 2. Alokasi Risiko

4.3 Variasi
4.3.1 Tidak ada biayaVKenaikan
biaya
mengurangi
kelayakan proyek
Pengenalan
organisasi
&
peraturan
ICE/PSV
4.3.2 Perubahan oleh
pemerintah
VKenaikan
biaya,
proyek terlambat
Penetapan
lingkup,
pembayaran
perubahan
4.3.3 Perubahan oleh
BUJT
VPenghematan
biaya, percepatan
proyek
Persetujuan
tidak
ada biaya & waktu
tambahan
4.4
Lapangan
dan
ROW
VKenaikan
biaya,
terlambat
Pemecahan
masalah
&
pembayaran
kompensasi
5.
Operasi/Pemeliharaan
5.1 Pemeliharaan
5.1.1 Staf/peralatanVPengurangan
standar,
kurang
pemeliharaan,
penurunan aset
Penetapan
penuh
sejak awal
5.1.2
Standar
pemeliharaan
VPenurunan asetPenetapan
penuh
sejak
awal
&
peran pengawasan
5.1.3KualitasV
Pemeliharaan
5.1.4
Kondisi
Serah
terima
V
5.2 Operasi
5.2.1 Staf/PeralatanVPengurangan
kapasitas
&
kompromi
keselamatan
Penetapan
penuh
sejak awal
5.2.2 Kriteria operasiV
5.2.3Peningkatan
teknologi
VPeralatan kuno &
tidak
sesuai
kondisi,
penurunan aset
Ijin
peningkatan
selama
masa
konsesi
5.2.4 AkuntabilitasV

Sambungan........ Tabel 2. Alokasi Risiko

6. Pendapatan
6.1 Lalu lintasVKaitan
studi
ekonomi & studi
swasta
harus
saling melengkapi
Pemenuhan
petunjuk
Studi
kelayakan
&
perencanaan
6.1.1
Vol/Komposisi
over estimate
VBila lebih rendah,
arus
pendapatan
tertekan
Pemenuhan study
secara profesional
6.1.2
Jaringan
jalan
saingan
VLalu
lintas
berkurang karena
ada yang beralih
Jaminan
Pemerintah
terhadap
jaringan
atau
pemberian
kompensasi
6.1.3
Keengganan
bayar tol
VLalu
lintas
berkurang karena
keengganan bayar
Dianalisis
dalam
studi kelayakan
6.2 Pengumpulan Tol
6.2.1 Perlawanan
sosial
VKapitalisasi
politis,
demonstrasi sosial
dan
hambatan
konstruksi/
operasi
Pelihara alternatif
non
tol
&
keterlibatan
masyarakat
6.2.2 Kepatuhan tarif
awal
VPemerintah
berpotensi default,
pendapatan
tol
tertekan
Pemerintah
memberikan
kompensasi
6.2.3 Kepatuhan naik
tarif
V
6.2.4 Pendapatan lainVPendapatan
berkurang
dari
tingkat proyeksi
BUJT
mencari
alternatif sumber

Sumber : Diterjemahkan dari PPITA 2005

Dari tabel diatas, terlihat bahwa alokasi risiko ini belum sepenuhnya seimbang antara Pemerintah dengan Badan Usaha, dalam hal ini risiko tersebut lebih banyak berada pada Badan Usaha. Untuk membuat investasi jalan tol ini menjadi lebih menarik, mungkin diperlukan negosiasi re-alokasi dan pengaturan kebijakan yang lebih adil.

Di kasus yang lain, Cariawan (2007) juga mengidentifikasi, mengevaluasi dan menganalisis risiko dalam bisnis jalan tol ini serta merumuskan alokasi pihak yang menanggung beserta tindakan yang dapat diambil seperti diperlihatkan dalam Tabel 3 berikut.

Tabel 3. Identifikasi dan Tingkat Risiko Serta Sikap dan Tindakan yang Dilakukan

TahapRisikoDampakKemung
kinan
Ting
kat
Peme
rintah
BUJTSikapTindakan
Inisiasi
Proyek
Biaya
tender
RendahTerkadangRendahVTerimaDijaga
Biaya
Konsultan
RendahTerkadangRendahVTerimaDijaga
Persiapan
Konstruksi
Biaya
Pendanaan
SedangMungkinSedangVHindariHedging
Biaya
Perubahan
Nilai
SedangMungkinSedangVHindariMinta
Jaminan
Biaya
Pengadaan
Lahan
SedangSeringBesarVHindariMinta
Jaminan
Perubahan
trase jalan
SedangMungkinSedangVHindariMinta
Jaminan
KonstruksiBiaya
tambahan
SedangMungkinSedangVHindariJaga
Pengelolaan
proyek
Waktu
tambahan
SedangMungkinSedangVHindariJaga
Pengelolaan
proyek
OperasiTarif
awal
rendah
SedangMungkinSedangVHindariMinta
Jaminan
Kenaikan
tarif
tidak
sesuai
SedangMungkinSedangVHindariMinta
Jaminan
Lalu lintas
kurang
SedangMungkinSedangVHindariKaji
ulang
studi
Perubahan
jaringan
jalan
SedangMungkinSedangVHindariMinta
Jaminan
Perubahan
kebijakan
pemerintah
SedangMungkinSedangVHindariMinta
Jaminan

Sumber : Dikompilasi dan diterjemahkan dari Cariawan, 2007

Dalam kasus ini, analisis risiko yang dilakukan relatif lebih sederhana, namun BUJT cenderung untuk banyak menghindari risiko yang dapat timbul atau meminta jaminan. Dari tabel ini juga terlihat bahwa risiko terbesar yang diperkirakan akan timbul adalah yang berhubungan dengan masalah pembebasan lahan.

Dari 3 analisis risiko yang disampaikan, terlihat bahwa untuk bisnis jalan tol ini risiko yang di identifikasi adalah dapat relatif berbeda, demikian pula presepsi dampak dan sikap serta tindakan yang diusulkan untuk diambil. Hal ini sedikit banyak dipengaruhi pula oleh metodologi dan presepsi pihak yang membuat analisis risiko tersebut. Namun demikian hasil akhir dan pengambilan keputusan dari penanganan risiko ini biasanya dilakukan dalam proses yang iteratif melibatkan negosiasi semua pihak terkait sehingga dapat dicapai kesepakatan yang dirasakan paling optimum bagi semua pihak dan dituangkan dalam perjanjian kontrak yang jelas dan mengikat.

Dalam prakteknya, proses negosiasi itu terjadi dalam perumusan kontrak konsesi atau yang disebut Perjanjian Pengusahaan Jalan Tol (PPJT). Dalam kasus yang selama ini terjadi, tidak jarang dalam proses ini Pemerintah diminta untuk mengeluarkan kebijakan/peraturan baru agar klausul-klausul dalam kontrak bisa mengurangi risiko yang mungkin bisa timbul serta lebih seimbang dan adil alokasinya. Contohnya adalah, seperti misalnya risiko kelambatan pembebasan lahan (yang sangat ditakuti Badan Usaha dan sangat besar risikonya), yang sebelumnya ditanggung oleh Badan Usaha, dicoba untuk ditanggulangi dengan dikeluarkannya kebijakan penggunaan Dana Talangan dari Pemerintah untuk hal tersebut. Demikian pula dengan risiko lonjakan harga pembebasan lahan ini yang dapat menyebabkan investasi jalan tol ini menjadi tidak layak, dicoba ditanggulangi pemerintah dengan penyediaan Land Capping, dimana kelebihan dana tanah yang diperlukan dapat ditanggung oleh pemerintah dengan suatu pengaturan tertentu. Demikian pula halnya dengan risiko penyesuaian tarif, yang dimasa lalu sangat tidak menentu kepastiannya, sekarang sudah lebih dijamin dengan adanya UU no 34 tahun 2004, tentang Jalan, dan Peraturan Pemerintah no 15 tahun 2005, tentang Jalan Tol.

IV. IMPLIKASI TERHADAP PARTISIPASI PEMERINTAH DAERAH

4.1 Peluang Partisipasi

Melihat besarnya skala pembangunan jalan tol yang akan dilaksanakan tersebut berikut potensi didalamnya, maka terbuka lebar peluang Pemerintah Daerah untuk ikut berperan dan berpartisipasi. Peran Pemerintah Daerah ini tidak hanya menyangkut masalah yang terkait dengan kewenangan dan peraturan saja, tapi juga termasuk ikut terlibat dalam dunia usahanya sendiri (misalnya melalui Badan Usaha Milik Daerah).

Banyak sekali keuntungan yang dapat dinikmati daerah dengan adanya pembangunan jalan tol ini. Diantaranya adalah dalam hal pengembangan

wilayah dan pelibatan masyarakat dalam pembangunan jalan tol, baik secara langsung sebagai pekerja di dunia konstruksi maupun tidak, yaitu yang terkena imbas pembangunan infrastruktur sebagai akibat dari multiflyer effectnya, yang berarti terciptanya lapangan kerja bagi penduduk setempat dan terpakainya produk maupun material lokal.

Dalam hal ini, peran Pemerintah Daerah yang sangat penting erat terkait dengan masalah pemebebasan lahan yang banyak dianggap sebagai risiko paling tinggi, sementara hal lainnya adalah terkait dengan risiko pada masalah perijinan dan pengusahaan yang bersifat lokal/regional.

Pada saat ini ada kecenderungan baru, dimana para Pemerintah Daerah tidak hanya terlibat dalam perijinan pembangunan saja, namun juga sudah ada yang menjajagi untuk turut serta sebagai bagian dari investor juga. Dengan demikian maka kemampuan finansial dari Pemerintah Daerah juga sangat menentukan kesuksesan perubahan peran ini.

Dalam hal ini pelibatan Pemerintah Daerah melalui Badan Usaha Milik Daerah (BUMD) dalam pola baru tersebut adalah dengan menanggung sebagian biaya yang akan dihitung sebagai saham dalam keseluruhan biaya investasi. Namun dalam hal ini mungkin diperlukan suatu peraturan atau ijin pemerintah, atau Dewan Perwakilan Rakyat Daerah, untuk memastikan diperbolehkannya penyertaan saham tersebut.

4.2 Implikasi Risiko

Berdasarkan peran apa yang akan diambil oleh Pemerintah Daerah (apakah sebagai pemerintah semata-mata yang turut mengatur pemberian ijin, ataukah sekaligus terlibat sebagai investor melalui BUMD nya, maka implikasi risiko dan konsekuensi yang akan dihadapinya juga tentu berbeda.

Dilihat dari sudut pandang sebagai bagian dari pemerintah, ini, maka risiko yang ditanggung akan relatif kecil dari keseluruhan risiko yang ada, selain karena kebijakan alokasi risiko yang terjadi masih belum seimbang antara porsi Pemerintah dengan Badan Usaha, juga karena porsi pemerintah disini hampir seluruhnya masih ditanggung oleh Pemerintah Pusat (Nasional).

Namun apabila Pemerintah Daerah tersebut juga berperan sebagai investor, maka secara otomatis semua risiko yang akan ditanggung oleh Badan Usaha akan menjadi risiko Pemerintah Daerah pula. Tetapi secara keseluruhan, dalam kasus ini mungkin risiko yang akan dihadapi dapat berkurang, baik jumlah maupun kemungkinan terjadinya. Karena dengan peran gandanya tersebut, pemerintah akan berusaha untuk menghindari risiko semaksimal mungkin

V. PENUTUP

Dari gambaran uraian singkat diatas didapatkan gambaran tentang potensi investasi dan risikonya didalam pelaksanaan pembangunan jalan tol di Indonesia, yang walaupun sangat berpeluang besar namun banyak juga risiko yang harus dihadapi. Terutama terkait dengan lama/panjangnya siklus proyek dan besarnya investasi yang dilakukan.

Manajemen Risiko merupakan cara untuk mengelola risiko tersebut sejak dini, agar investasi yang dilakukan dapat lebih terukur dan tidak gagal ditengah jalan. Jenis dan besarnya risiko relatif bervariasi dan tergantung pada berbagai kondisi external dan internal baik dari pemerintah maupun investor. Demikian juga penyikapan dan pengambilan strategi terhadap risiko tersebut tidak selalu sama untuk setiap kasus, hal ini sangat tergantung pada analisis yang dilakukan dan presepsi tentang risiko yang dihadapi beserta perilaku dan keyakinan para pihak yang terkait untuk menghadapinya.

Pemerintah Daerah dapat turut berpartisipasi dalam pembangunan jalan tol ini dengan berperan sebagai regulator ataupun turut sebagai investor, melalui Badan Usaha Milik Daerah. Hal ini memberikan implikasi yang berbeda terhadap risiko yang mungkin timbul

VI. DAFTAR PUSTAKA

Badan Pengatur Jalan Tol (BPJT) ( 2007), Peluang Investasi Jalan Tol di Indonesia

Cariawan, Unggul (2007), Risk Management System Development in PT Jasa Marga (Persero), Joint Technical Conference, Penang, Malaysia.

Dalijus, Beta Proton, (2007), Identifikasi Risiko Investor Dalam Investasi Jalan Tol, Thesis Program Studi Teknik Sipil, Universitas Indonesia

Jasa Marga (2007), Manual Pengendalian Risiko

Okamoto, Kanemura, Mitsuishi (2007), Risk Management Project at Expressway Companies, Joint Technical Conference, Penang, Malaysia.

PPITA (2005), Risk Allocation Table, Laporan Untuk Project Management Unit, Departemen Pekerjaan Umum.

Peraturan Pemerintah (PP) no 15 (2005), Tentang Jalan Tol

Sihombing, Bastian S. (2003) Konsep Manajemen Risiko pada PT Jasa Marga (Persero), Laporan internal (tidak dipublikasikan) untuk PT Jasa Marga.

Sunito, Frans (2005), Kajian Risiko Bisnis Jalan Tol, Makalah Pada Seminar Manajemen Risiko, PT Jasa Marga.

Undang-Undang (UU) no 38 (2004), tentang Jalan

References

  1. Badan Pengatur Jalan Tol (BPJT) ( 2007), Peluang Investasi Jalan Tol di Indonesia
  2. Cariawan, Unggul (2007), Risk Management System Development in PT Jasa Marga (Persero), Joint Technical Conference, Penang, Malaysia.
  3. Dalijus, Beta Proton, (2007), Identifikasi Risiko Investor Dalam Investasi Jalan Tol, Thesis Program Studi Teknik Sipil, Universitas Indonesia
  4. Jasa Marga (2007), Manual Pengendalian Risiko
  5. Okamoto, Kanemura, Mitsuishi (2007), Risk Management Project at Expressway Companies, Joint Technical Conference, Penang, Malaysia.
  6. PPITA (2005), Risk Allocation Table, Laporan Untuk Project Management Unit, Departemen Pekerjaan Umum.
  7. Peraturan Pemerintah (PP) no 15 (2005), Tentang Jalan Tol
  8. Sihombing, Bastian S. (2003) Konsep Manajemen Risiko pada PT Jasa Marga (Persero), Laporan internal (tidak dipublikasikan) untuk PT Jasa Marga.
  9. Sunito, Frans (2005), Kajian Risiko Bisnis Jalan Tol, Makalah Pada Seminar Manajemen Risiko, PT Jasa Marga.
  10. Undang-Undang (UU) no 38 (2004), tentang Jalan
